The Abuja Team tracked 25 projects between 17th and 20th September 2021. The projects are located in Abaji, Kwali and Gwagwalada Area Councils namely:
(I) Award of contract for construction of 2No motorized Borehole in FCT Senatorial District. Contractor: Messrs Valob Cielos Integrated.
Contract sum: N16,000,000.00. (2019).
Executing Agency: UNRBDA.

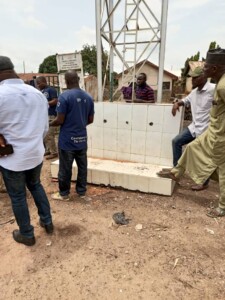

The Borehole is located at Rimba, Abaji. The contract was executed but not functional at the time of the visit.
QS report awaited further action.
(II) Award of contract for construction of 1No. Health care in Abaji Area Council FCT Senatorial District.
Contractor: Equal Project Ltd.
Contract sum: N40,274,004.76 (2020).
Executing Agency: UNRBDA.
The project is located at Rimba. The project is executed. No burglary was sighted. The project is not in use.
QS report to determine further action.

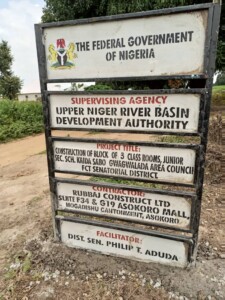

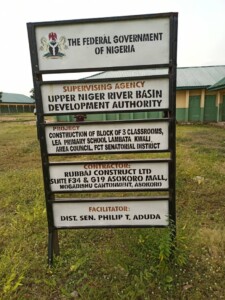

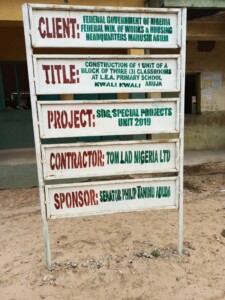

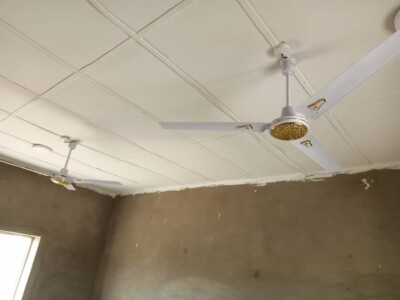

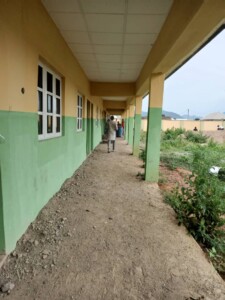

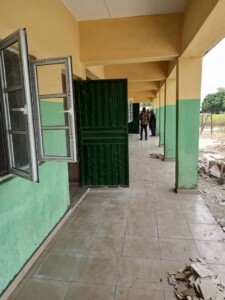

(III) Award of contract for construction of 9Nos Block of classrooms at Nanda and Nunku, Abaji Area Councils, 4No at Orozo and Jiwa AMAC, 1 No Dutse, Bwari Area Council, FCT.
Contractor: Messrs Najori Nig. Ltd.
Contract sum: N126,000,000.00 (2019).

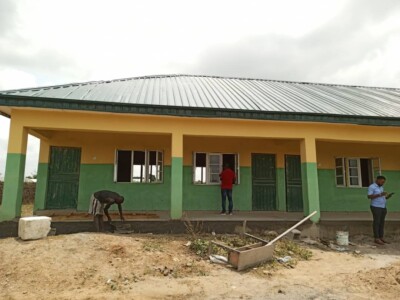

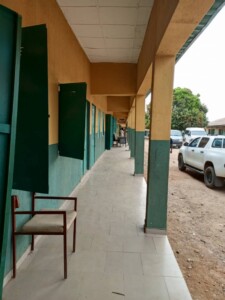

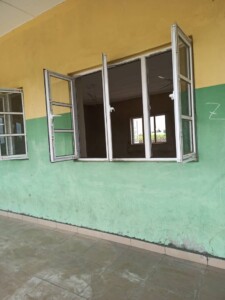

The project is located at Nanda, Abaji. 2 units Block of 3 classrooms was constructed.
QS report to determine further action.
(IV) Award of contract for the training and empowerment of women and youth in Abaji, Kwali, Gwagwalada and Kuje Area Councils of Abuja South Federal Constituency.
Contractor: Al-Jabil Integrated Services Ltd.
Contract sum: N149,945,678.00 (2020).
Executing Agency: National Tuberculosis & Leprosy Training Center (Federal Ministry of Health).
Sponsor: Hon. Hassan Usman Sakodabo.
The team interacted with some of the beneficiaries in Abaji. Further investigation to determine the level of compliance in line with the BOQ.
(V) Grants to students and market women in Abaji, Gwagwalada, Kuje and Kwali Area Councils.
Contractor: First Multiple Microfinance Bank Ltd.
Contract sum: N19,000,000.00 (2020).
Executing Agency: SMEDAN.
Sponsor: Hon Hassan Usman Sakodabo.
The team also interacted with the beneficiaries of the grants. Further investigation to determine the level of compliance.
(VI) Award of contract for the provision of strategic empowerment program in Abaji Area Council. Phase I.
Contractor: FINAQUEST Integrated Resources Ltd.
Contract sum: N6,647,406.15. (2020).
Phase II.
Contractor: Same as above.
Contract sum: N4,967,460.75.
(VII) Award of contract for the provision of Entrepreneurship Development Training in Abaji Area Council, FCT.
Contractor: AIMAM Integrated Synergy Ltd.
Contract sum: N6,000,000.00 (2020). Phase I.
Executing Agency: SMEDAN.
Phase II.
Contractor: Same as above.
Contract sum: N4,500,000.00. Phase III.
Contractor: Same as above
Contract sum: N1,395,345.83.
Sponsor: Hon Hassan Usman Sakodabo
The team also interacted with the beneficiaries and attested to the fact that the program was executed and beneficial to them. Further investigation to determine the level of compliance.

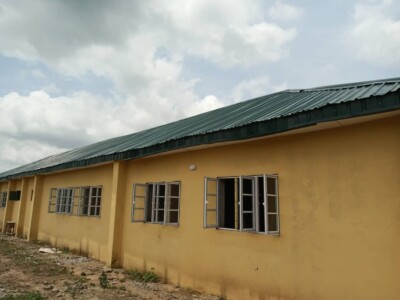

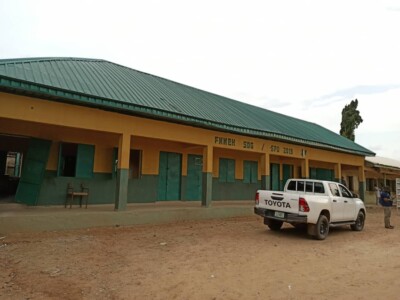

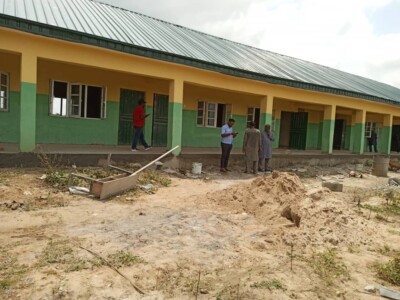

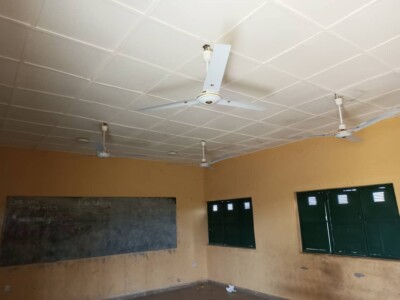

(VIII) Construction of 2 units of classrooms at Science Primary School Nunku, Abaji Area Council.
Contractor: Najori Nig. Ltd.
Contract sum: N126,000,000.00 (2019).
Executing Agency: Federal Ministry of Works and Housing.
The contract was executed.
QS report awaited further action.

(IX) Award of Contract for Rehabilitation of Boreholes in FCT Senatorial District (Kwali and Abaji Area Councils).
Contractor: Courage Medals Nig. Ltd.
Contract sum: N11,870,000.00 (2019).
The Borehole is located at Ribochi, Kwali Area Council. As of the time of visit the Borehole is not functional. The residents averred that the Borehole stopped functioning for the last 2 months ago.

(X) Award of contract for construction of drainage at Federal Government College Ribochi, Abuja, FCT.
Contractor: M/S Hasib Services Ltd.
Contract sum: N18,390,036.68 (2019).
Executing Agency: Federal Ministry of Education.
The contract was executed.
QS report to determine further action.
(XI) Award of contract for the provision of security infrastructure in Federal Government College Rubochi, Abuja, FCT.
Contractor: M/S Expedition Engineering Ltd.
Contract sum: N16,426,187.59 (2019).
Executing Agency: Federal Ministry of Education.
The contract was executed.
QS report to determine further action.
(XIII) Award of contract for construction of 2No motorized Borehole in FCT Senatorial District.
Contractor: GS. ES Nig Ltd.
Contract sum: N15,417,778.95 (2019).
Executing Agency: UNRBDA.
The project is located at Orukpisaka, Abaji Area Council.
The project is executed.
Functional at the time of visit.
QS report to determine further action.

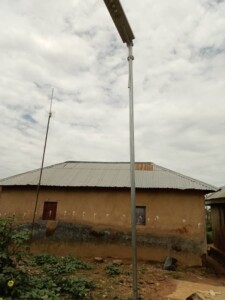

(IV) Award of contract for the provision of solar street lights in FCT. Contractor: Messrs Equal Project Ltd.
Contract sum: N94,655,076.75 (2019).
Executing Agency: UNRBDA.

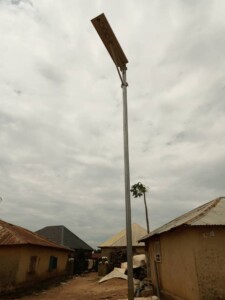

Parts of the solar street lights were located at old market road, Abaji (20Nos) were installed. And also 5 Nos were installed at Sabon Tasha, Abaji.
